In 2014, Atascadero voters approved a ballot measure (F-14) which authorized the City to increase its sales tax rate by a ½ percent for a term of 12 years, together with a measure (E-14) advising that the funds be primarily utilized for maintaining and repairing neighborhood roads. While the City will continue to maintain and improve arterial roadways, funds approved under Measure F-14 are specifically earmarked for the improvements of neighborhood roads. The measures became effective April 1, 2015, and will sunset on April 1, 2027 unless renewed by the voters. The measure includes a nine-member Citizen Oversight Committee tasked with reviewing revenues, expenditures, and the annual road report.
Since that time, Measure F-14 has funded:
- Nearly $14M in neighborhood road repair
- Resurfaced or rehabilitated over 42 miles of neighborhood roads, including the removal and replacement of asphalt on full roadway sections where needed.
- Improved drainage & roadside slope stability.
- Construction Update
- Road Reports
- Interactive Map
- Sales Tax Oversight Committee
- Upcoming Projects
- Completed Projects

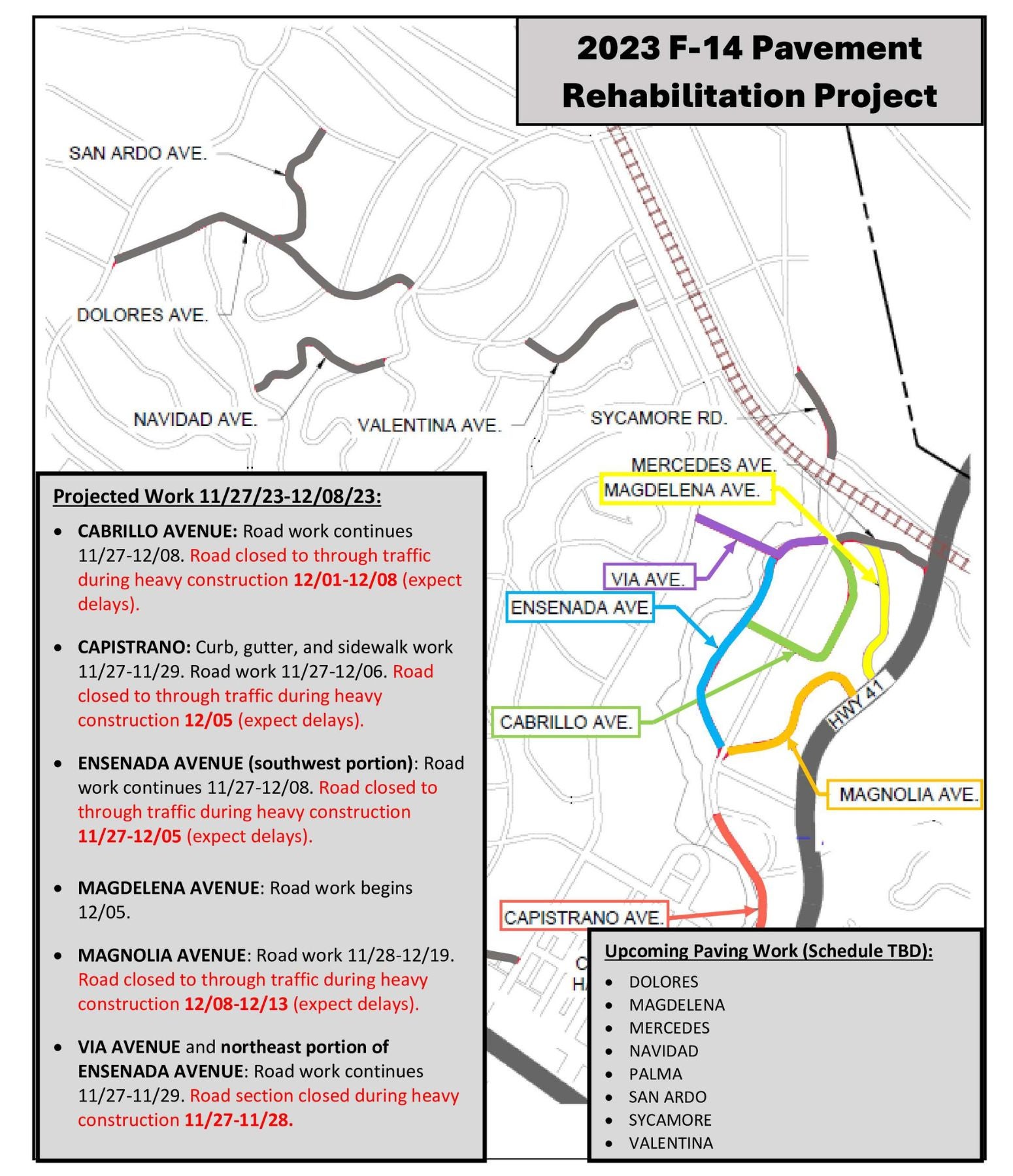

Week of 11/27/23-12/01/23:
• CABRILLO AVENUE: Road work continues 11/27-12/08. Road closed to through traffic during heavy construction 12/01-12/08 (expect delays).
• CAPISTRANO: Curb, gutter, and sidewalk work 11/27-11/29. Road work 11/27-12/06.
• ENSENADA AVENUE (southwest portion): Road work continues 11/27-12/08. Road closed to through traffic during heavy construction 11/27-12/05 (expect delays).
• MAGNOLIA AVENUE: Road work 11/28-12/19.
• VIA AVENUE and northeast portion of ENSENADA AVENUE: Road work continues 11/27-11/29. Road section closed during heavy construction 11/27-11/28.
Week of 12/04/23-12/08/23:
• CABRILLO AVENUE: Road work continues through 12/08. Road closed to through traffic during heavy construction 12/01-12/08 (expect delays).
• CAPISTRANO: Road work through 12/06. Road closed to through traffic during heavy construction on 12/05 (expect delays).
• ENSENADA AVENUE (southwest portion): Road work through 12/08. Road closed to through traffic during heavy construction 11/27-12/05 (expect delays).
• MAGDELENA AVENUE: Road work begins 12/05.
• MAGNOLIA AVENUE: Road work continues. Road closed to through traffic during heavy construction 12/08-12/13 (expect delays).
The City of Atascadero is pleased to announce that road construction for the 2023 F-14 Pavement Rehabilitation Project commenced in mid-August, 2023, and consists of pavement rehabilitation for a total of 3.3 miles of roadway, including:
1. Cabrillo Avenue (Ensenada to Capistrano)
2. Capistrano Avenue (West Mall to Lewis)
3. Dolores Avenue (San Anselmo to San Jacinto)
4. Ensenada Avenue (West End to Capistrano)
5. Magdelena Avenue (Mercedes to end)
6. Magnolia Avenue (Capistrano to end)
7. Mercedes Avenue (Capistrano to Highway 41)
8. Navidad Avenue (El Verano to San Jacinto)
9. Palma Avenue (Traffic Way to Rosario)
10. San Ardo Avenue (Arena to Dolores)
11. Sycamore Road (Miramon to Capistrano)
12. Valentina Avenue (Dolores to Alamo)
13. Via Avenue (Traffic Way to Ensenada)
Roadway treatments range from light resurfacing to full reconstruction, depending upon current condition of the road.
Souza Construction has been hired by the City to complete construction for this project, which should last approximately 5 months. Driveway access to and from all roadways will be maintained during construction. However, there may be short periods of time (typically 15-30 minutes) when your driveway cannot be accessed, to accommodate construction work. The City and its contractor will work closely with you to minimize this inconvenience while allowing the construction to progress. During pavement rehabilitation, motorists are encouraged to pay close attention to the traffic signage and plan for extra time if travel through the area is necessary. Please drive carefully through the work zones and be considerate of both other drivers and workers. Large trucks, trailers, and recreational vehicles should use alternative routes where possible.
If you have any questions or concerns regarding this project, please contact Atascadero Public Works at 805-470-3456 or publicworks@atascadero.org.
2022 Community Road Report
- 2022 Pavement Rehabilitation - 3.27 miles
- Ardilla Rd (North End to Balboa Rd)
- Balboa Rd (Santa Ana Rd to San Fernando Rd)
- Cebada Rd (Santa Ana Rd to End)
- Cenegal Rd (End to Laurel Rd)
- Corriente Rd (San Fernando Rd to Santa Ana Rd)
Prior Years 2015-2020 | FY 2021 | FY 2022 | Totals as of 6/30/2022 | |
Revenues: | ||||
Sales Tax | $11,828,438 | $2,832,052 | $3,212,014 | $17,872,504 |
Interest Income | $208,223 | $55,851 | $41,533 | $305,607 |
Adjustment to Fair Market Value | $97,379 | $(44,415) | $(157,734) | $(104,770) |
Total Revenues | $12,134,040 | $2,843,488 | 3,095,813 | $18,073,341 |
Expenditures: | ||||
Total expenditures | $7,894,515 | $2,608,155 | $3,363,273 | $13,865,943 |
Net change in fund balance | $4,239,525 | $235,333 | $(267,460) | $4,207,398 |
Fund Balance - beginning of year | $4,239,525 | $4,474,858 | ||
Fund Balance - End of year | $4,239,525 | $4,474,858 | $4,207,398 | $4,207,398 |
2021 Community Road Report
- 2021 Pavement Rehabilitation* - 3.81 miles
- Alegre Ave (Atascadero Ave to End)
- Coromar Ave (Marchant Ave to Portola Rd)
- La Paz Ln (Atascadero Ave to End)
- Marchant Way (Pismo Ave to Santa Rosa Rd)
- Marchant Ave (Coromar Ave to Atascadero Ave)
- Old Morro Rd East (Hwy 41 to Hwy 41)
- Pismo Ave (Hwy 41 to Marchant Way)
- San Diego Rd (Atascadero Ave to Hwy 101 on-ramp)
- San Guillermo Ln (San Gabriel Rd to End)
- San Rafael Rd (San Gabriel Rd to Los Osos Rd)
- 2021 Pavement Resurfacing - 2.48 miles
- El Dorado Rd (Santa Fe Rd to La Linia Ave)
- Halcon Rd (Viejo Camino to Calle Milano)
- Las Lomas Ave (North End to Principal Ave)
- Mountain View Dr (Portola Rd to Santa Rosa Rd)
- Plata Ln (West End to El Camino Real)
- Pueblo Ave (San Luis Ave to El Camino Real)
- San Gabriel Rd (Atascadero Ave to West Front Rd)
- San Luis Ave (Pueblo Ave to Curbaril Ave)
- San Rafael Rd (Atascadero Ave to West Front Rd)
- Solano Ave (El Camino Real to La Linia Ave)
* Construction no complete prior to end of fiscal year - remaining budgeted expenditures: $2,871,078
Prior Years 2015-2019 | FY 2020 | FY 2021 | Totals as of 6/30/2021 | |
Revenues: | ||||
Sales Tax | $9,345,195 | $2,483,243 | $2,832,052 | $14,660,490 |
Interest Income | $134,083 | $74,140 | $55,851 | $264,074 |
Adjustment to Fair Market Value | $16,006 | $81,373 | $(44,415) | $52,964 |
Total Revenues | $9,495,284 | $2,638,756 | $2,843,488 | $14,977,528 |
Expenditures: | ||||
Total expenditures | $5,503,326 | $2,391,189 | $2,608,155 | $10,502,670 |
Net change in fund balance | $3,991,958 | $247,567 | $235,333 | $4,474,858 |
Fund Balance - beginning of year | $3,991,958 | $4,239,525 | ||
Fund Balance - End of year | $3,991,958 | $4,239,525 | $4,474,858 | $4,474,858 |
2020 Community Road Report
- 2020 Pavement Rehabilitation* - 4.24 miles
- Gabarda Rd (Curbaril Ave to Tampico Rd, to End)
- Junipero Ave (El Camino Real to end)
- Palomar Ave (El Camino Real to Castano Ave)
- Pueblo Ave (El Camino Real to Sombrilla Ave)
- Robles Ave (Santa Ysabel Ave to Sombrilla Ave)
- Sinaloa Ave (Pueblo Ave to Curbaril Ave)
- Sombrilla Ave (Robles Ave to Curbaril & Robles to end)
- Sonora Ave (Valle Ave to Pinal Ave)
- Valle Ave (North end to Escarpa Ave & Escarpa Ave to Curbaril Ave)
* Construction not complete prior to end of fiscal year – remaining budgeted expenditures: $2,620,869
Prior Years 2015-2018 | FY 2019 | FY 2020 | Totals as of 6/30/2020 | |
Revenues: | ||||
Sales Tax | $6,994,183 | $2,351,012 | $2,483,243 | $11,828,438 |
Interest Income | $70,971 | $63,112 | $74,140 | $208,223 |
Adjustment to Fair Market Value | $(32,804) | $48,810 | $81,373 | $97,379 |
Total Revenues | $7,032,350 | $2,462,934 | $2,638,756 | $12,134,040 |
Expenditures: | ||||
Total expenditures | $4,047,028 | $1,456,298 | $2,391,189 | $7,894,515 |
Net change in fund balance | $2,985,322 | $1,006,636 | $247,567 | $4,239,525 |
Fund Balance - beginning of year | $5,201,603 | $2,985,322 | $3,991,958 | |
Fund Balance - End of year | $8,186,925 | $3,991,958 | $4,239,525 | $4,239,525 |
2019 Community Road Report
- 2019 Pavement Rehabilitation* - 3.28 miles
- Balboa Rd (San Fernando Rd to Graves Creek Rd)
- Garcia Rd (Santa Cruz Rd to San Gregorio Rd)
- San Gregorio Rd (Del Rio Rd to Garcia Rd)
- Del Rio Rd (Monterey Rd to San Gregorio Rd)
- Monterey Rd (Del Rio Rd to Campo Rd)
- Navarette Ave (Santa Lucia Rd to San Marcos Rd)
* Construction not complete prior to end of fiscal year – remaining budgeted expenditures: $2,593,635
Prior Years 2015-2017 | FY 2018 | FY 2019 | Totals as of 6/30/2019 | |
Revenues: | ||||
Sales Tax | $4,686,814 | $2,307,369 | $2,351,012 | $9,345,195 |
Use of money and property | $37,613 | $554 | $111,922 | $150,089 |
Total Revenues | $4,724,427 | $2,307,923 | $2,462,934 | $9,495,284 |
Expenditures: | ||||
Total expenditures | $2,362,684 | $1,684,344 | $1,456,298 | $5,503,326 |
Net change in fund balance | $2,361,743 | $623,579 | $1,006,636 | $3,991,958 |
Fund Balance - beginning of year | $2,839,860 | $2,361,743 | $2,985,322 | |
Fund Balance - End of year | $5,201,603 | $2,985,322 | $3,991,958 | $3,991,958 |
2018 Community Road Report
- 2018 Pavement Resurfacing* - 0.58 miles
- Capistrano Ave (Sycamore Rd to West Mall)
- 2018 Pavement Rehabilitation* - 2.38 miles
- Nogales Ave (Dolores Ave to Dulzura Ave)
- Rosario Ave (Traffic Way to El Camino Real)
- San Benito Rd (Colima Rd to Traffic Way)
- Tunitas Ave (Bajada Ave to Traffic Way)
* Construction not complete prior to end of fiscal year – remaining estimated expenditures: $1,675,968
Prior Years 2015-2016 | 2017 | 2018 | Totals as of 6/30/2018 | |
Revenues: | ||||
Sales Tax | $2,567,394 | $2,119,420 | $2,307,369 | $6,994,183 |
Use of money and property | $31,043 | $6,570 | $554 | $38,167 |
Total Revenues | $2,598,437 | $2,125,990 | $2,307,923 | $7,032,350 |
Expenditures: | ||||
Total Expenditures | $224,537 | $2,138,147 | $1,684,344 | $4,047,028 |
Net change to fund balance | $2,373,900 | ($12,157) | $623,579 | $2,985,322 |
Fund Balance - beginning of year | $2,373,900 | $2,361,743 | ||
Fund Balance - end of year | $2,373,900 | $2,361,743 | $2,985,322 | $2,985,322 |
2017 Community Road Report
- 2017 Pavement Resurfacing* - 2.35 miles
- Colorado Ave (San Rafael Rd to San Diego Wy)
- Estrada Ave (San Anselmo Rd to San Jacinto Ave)
- La Linia Ave (West end to El Dorado Rd)
- Navajoa Ave (Santa Ynez Ave to Curbaril Ave)
- Serra Ave (Atascadero Ave to San Andres Ave)
- Sycamore Rd (Hidalgo Ave to Miramon Ave)
- 2017 Pavement Rehabilitation**
- Alcantara Ave (Marchant Ave N to Marchant Ave S)
- Carmelita Road (Curbaril Ave to Portola Rd)
- Carmelita Road (Portola Road to San Gabriel Rd)
- Cortez Ave (Maleza Ave to Curbaril Ave)
- Monterey Road (Campo Rd to San Anselmo Rd)
* Construction not complete prior to end of fiscal year – remaining obligated expenditures: $ 56,193
** Construction not complete prior to end of fiscal year – remaining obligated expenditures: $ 1,868,663
2015 | 2016 | 2017 | Totals as of 6/30/2017 | |
Revenues: | ||||
Sales Tax | $472,278 | $2,095,116 | $2,119,420 | $4,686,814 |
Use of money and property | $257 | $30,786 | $6,570 | $37,613 |
Total Revenues | $472,535 | $2,125,902 | $2,125,990 | $4,724,427 |
Expenditures: | ||||
Total Expenditures | $6,575 | $217,962 | $2,138,147 | $2,362,684 |
Net change to fund balance | $465,960 | $1,907,940 | ($12,157) | $2,361,743 |
Fund Balance - beginning of year | $465,960 | $2,373,900 | ||
Fund Balance - end of year | $465,960 | $2,373,900 | $2,361,743 | $2,361,743 |
2016 Community Road Report
The following two projects were budgeted with Measure F-14 monies for fiscal year 2015-2016. Pavement testing and engineering design costs of $10,713 and $132,547 were incurred during the fiscal year ending June 30, 2016 for these projects, with the remaining budget spent for construction after June 30, 2016. These construction costs are not reflected in the financial summary below. The 2016 Maintenance Project included 1.76 miles of roadways, and the 2016 Rehabilitation Project included 2.43 miles of road improvements, for a total of 4.9 miles.
- 2016 Maintenance Project - 1.76 miles
- Arena Rd (San Benito Rd to Yerba Ave)
- Castano Ave (Curbaril Ave to Palomar Ave)
- San Vicente Ave (San Jacinto Ave to North End)
- 2016 Rehabilitation Project - 2.43 miles
- Yerba Ave (Estrada Ave to Dolores Ave.)
- Cascabel Rd (North End to Santa Lucia Rd)
- San Andres Ave (Santa Lucia Rd to San Marcos Rd)
- San Clemente Ave (Portola Rd to San Marcos East)
- Valle Ave (Curbaril Ave to Palomar Ave)
- Los Gatos Rd (Santa Lucia Rd to San Marcos Rd)
2016 | 2015 | |
Revenues: | ||
Sales Tax | $2,095,116 | $472,278 |
Interest | $30,786 | $257 |
Total Revenues | $2,125,902 | $472,535 |
Expenditures: | ||
Capital Outlay: | ||
Honda Ave | $37,809 | $3,287 |
Alamo Ave | $36,893 | $3,288 |
Pavement Maintenance Projects* | $10,713 | |
Pavement Rehabilitation Projects* | $132,547 | |
Total Expenditures | $217,962 | $6,575 |
Net Change in Fund Balance | $1,907,940 | $465,960 |
Fund Balance - Start of Fiscal Year | $465,960 | |
Fund Balance - End of Fiscal Year | $2,373,900 | $465,960 |
2015 Community Road Report
- 2015 Rehabilitation Project
- Alamo Ave (Rosario Ave to Barrenda Ave)
- Honda Ave (Traffic Way to Barrenda Ave)
2015 | |
Revenues: | |
Sales Tax | $472,278 |
Interest | $257 |
Total Revenues | $472,535 |
Expenditures: | |
Capital Outlay: | |
Honda Ave | $3,287 |
Alamo Ave | $3,286 |
Total Expenditures | $6,575 |
Net Change in Fund Balance | $465,960 |
Fund Balance - Start of Fiscal Year | |
Fund Balance - End of Fiscal Year | $465,960 |
Interactive Map of Project Roads
Click the link below to visit the interactive map.
Citizens’ Sales Tax Oversight Committee
The Citizens’ Sales Tax Oversight Committee (CSTOC) was established for the oversight of the 2014 Sales Tax Measure. The Committee shall annually review revenues and expenditures from the collection of the tax created by the adoption of Ordinance No. 581, and shall also review the Annual Road Report prepared by the City. The Committee shall, through the City Manager or her designee, submit the Committee’s findings and conclusions to the City Council.
The Citizen's Sales Tax Oversight Committee is comprised of nine community members; seven members appointed to the Committee by individual Atascadero community groups and two members appointed by the City Council. Appointees shall be residents of the City; however, no member of the Committee shall be an elected official.
2023 Projects
- 2023 Pavement Rehabilitation - 3.28 miles - $2,800,000
- Cabrillo Ave (Ensenada Ave to Capistrano Ave)
- Capistrano Ave (West Mall to Lewis Ave)
- Dolores Ave (San Anselmo Rd to San Jacinto Ave)
- Ensenada Ave (North End & Via Ave to Capistrano Ave)
- Magdelena Ave (Capistrano Ave to End)
- Magnolia Ave (Capistrano Ave to End)
- Mercedes Ave (Capistrano Ave to Hwy 41)
- Navidad Ave (El Verano Ave to San Jacinto Ave)
- Palma Ave (Traffic Way to Rosario Ave)
- San Ardo Ave (Arena Rd to Dolores Ave)
- Sycamore Rd (Miramon Ave South to Capistrano Ave)
- Valentina Ave (Dolores Ave to Alamo Rd)
- Via Ave (Traffic Way to Ensenada Ave)
2024 Projects

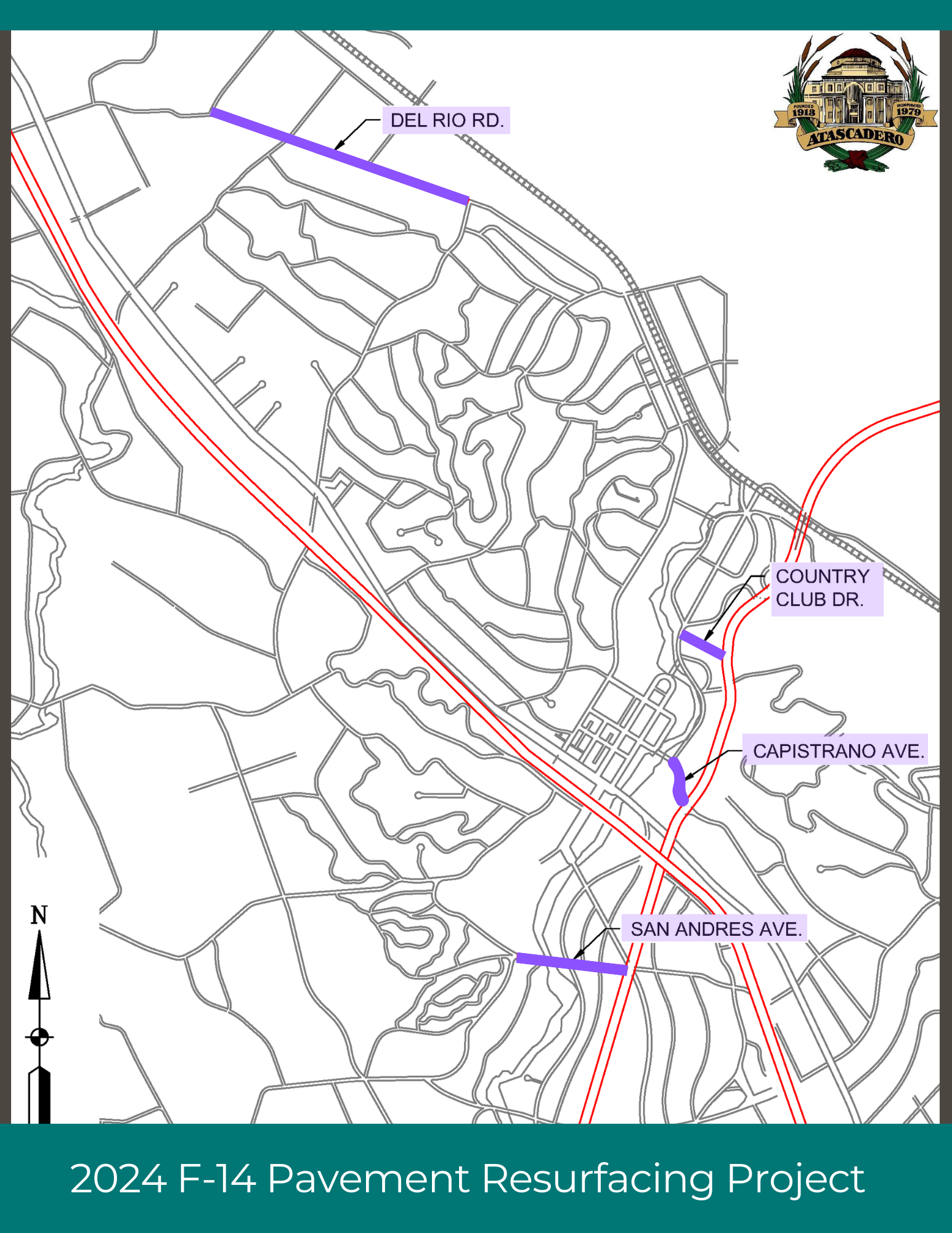

- 2024 Pavement Resurfacing - (North/Central) - 1.37 miles - $400,000
- Capistrano Ave (Lewis Ave to Hwy 41)
- Country Club Dr (Capistrano Ave to End)
- Del Rio Rd (Potrero Rd to San Anslemo Rd)

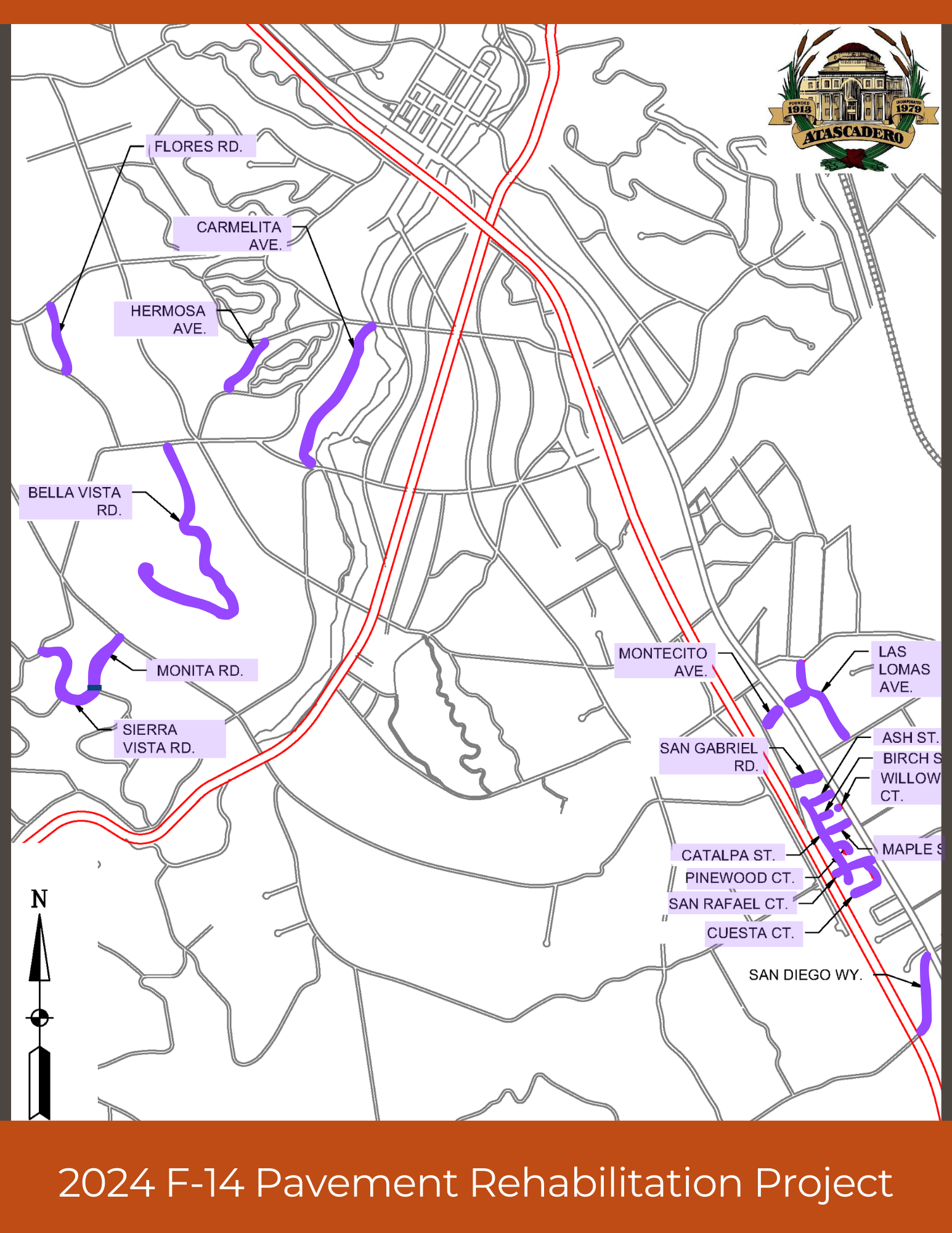

- 2024 Pavement Rehabilitation - (East/Central) - 3.37 miles - $2,900,000
- Ash St (Catalpa St to El Camino Real)
- Bella Vista Rd (San Marcos Rd to To End)
- Birch St (Catalpa St to To End)
- Carmelita Ave (San Andres Ave to Curbail Ave)
- Catalpa St (North End to San Rafael Ct)
- Flores Rd (Santa Lucia Rd to Los Gatos Rd)
- Hermosa Ave (Navarette Ave to San Clemente Ave)
- Las Lomas Ave (Principal Ave to El Bordo Ave)
- Maple St (Catalpa St to El Camino Real)
- Monita Rd (San Gabriel Rd to Sierra Vista Rd)
- Montecito Ave (East Front St to El Camino Real)
- Montecito Ave (El Camino Real to Las Lomas Ave)
- Pinewood Ct (Catalpa St to To End)
- San Diego Way (El Camino Real to US 101 NB Off Ramp)
- San Gabriel Rd (East Front St to El Camino Real)
- San Rafael Ct (West End to El Camino Real)
- Sierra Vista Rd (San Marcos Rd to Monita Rd)

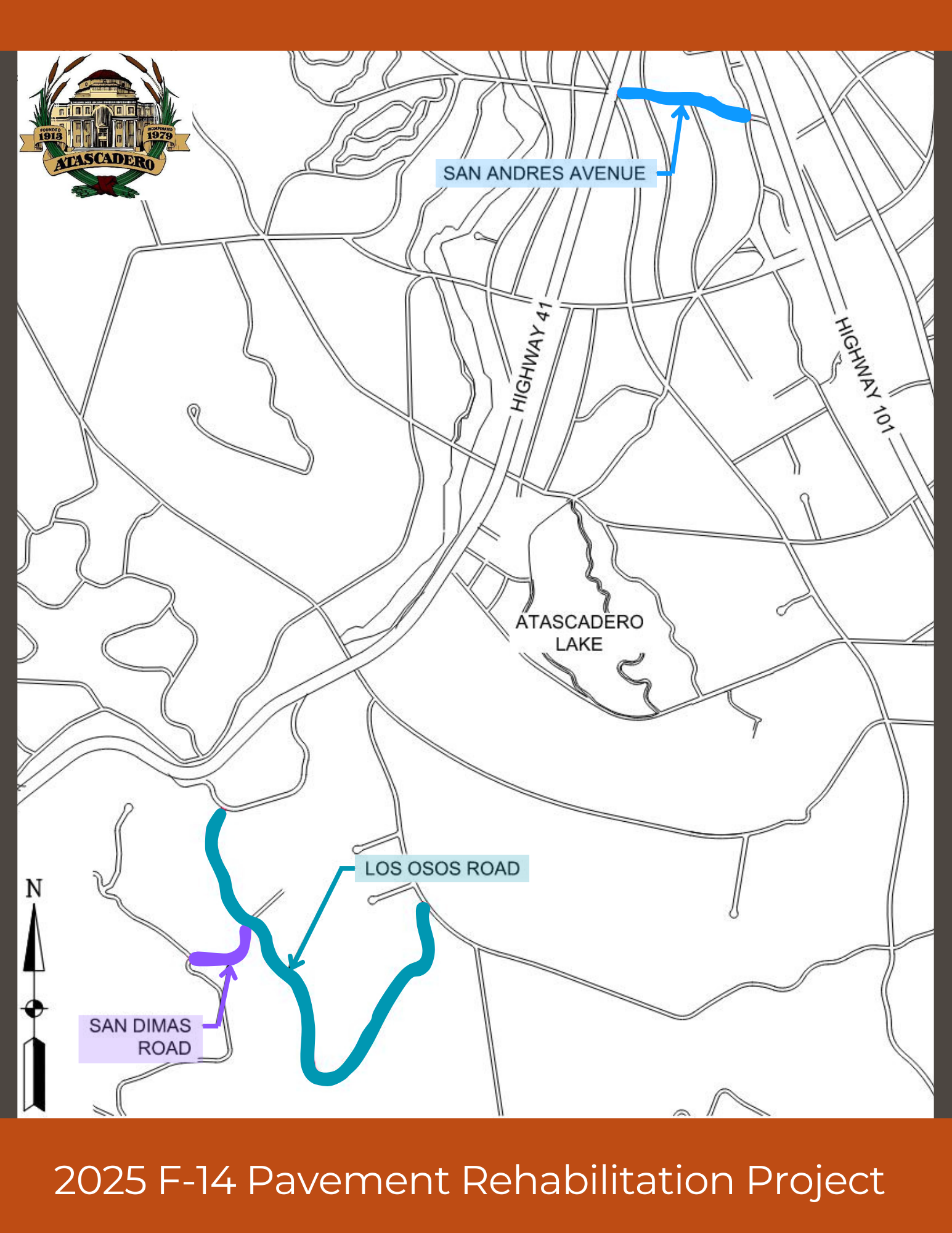

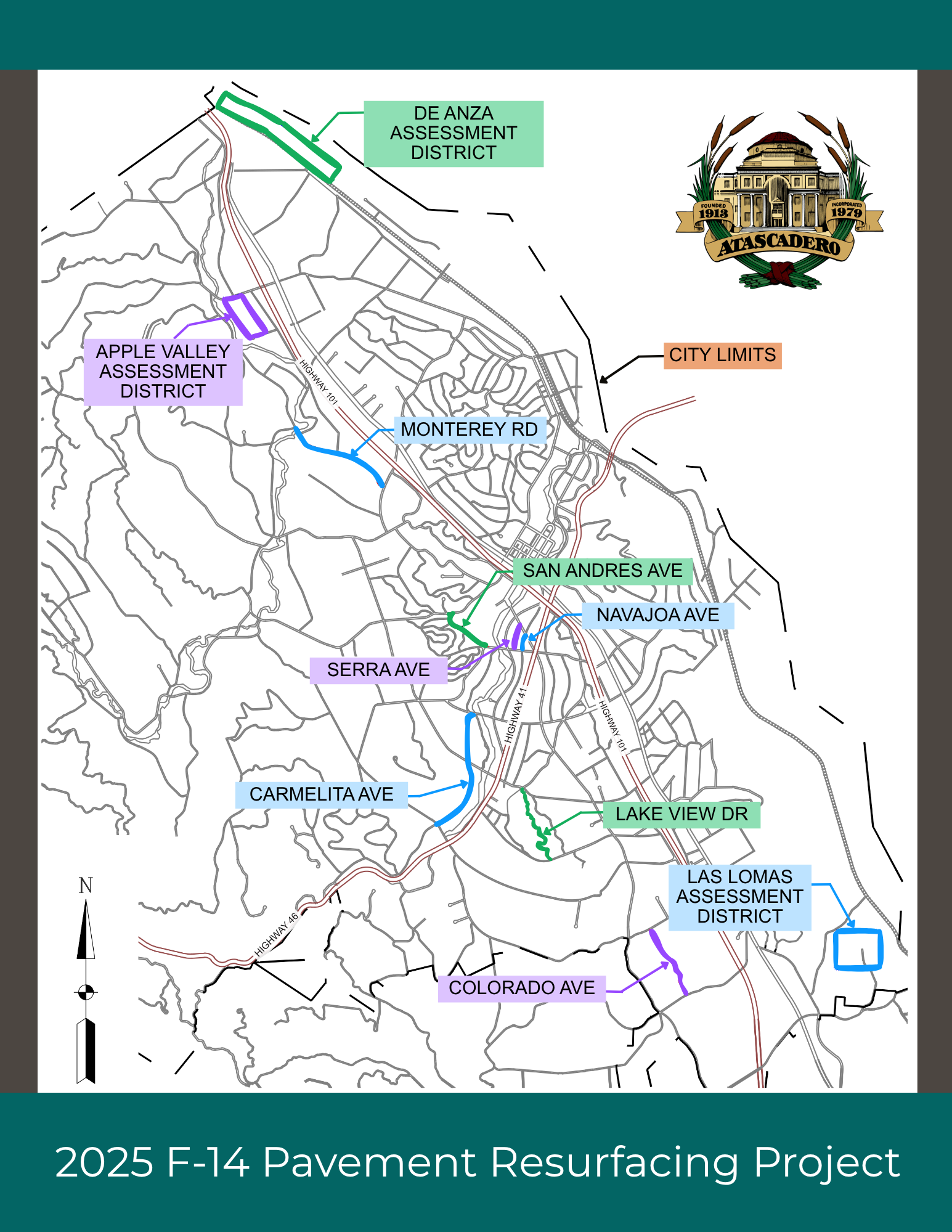

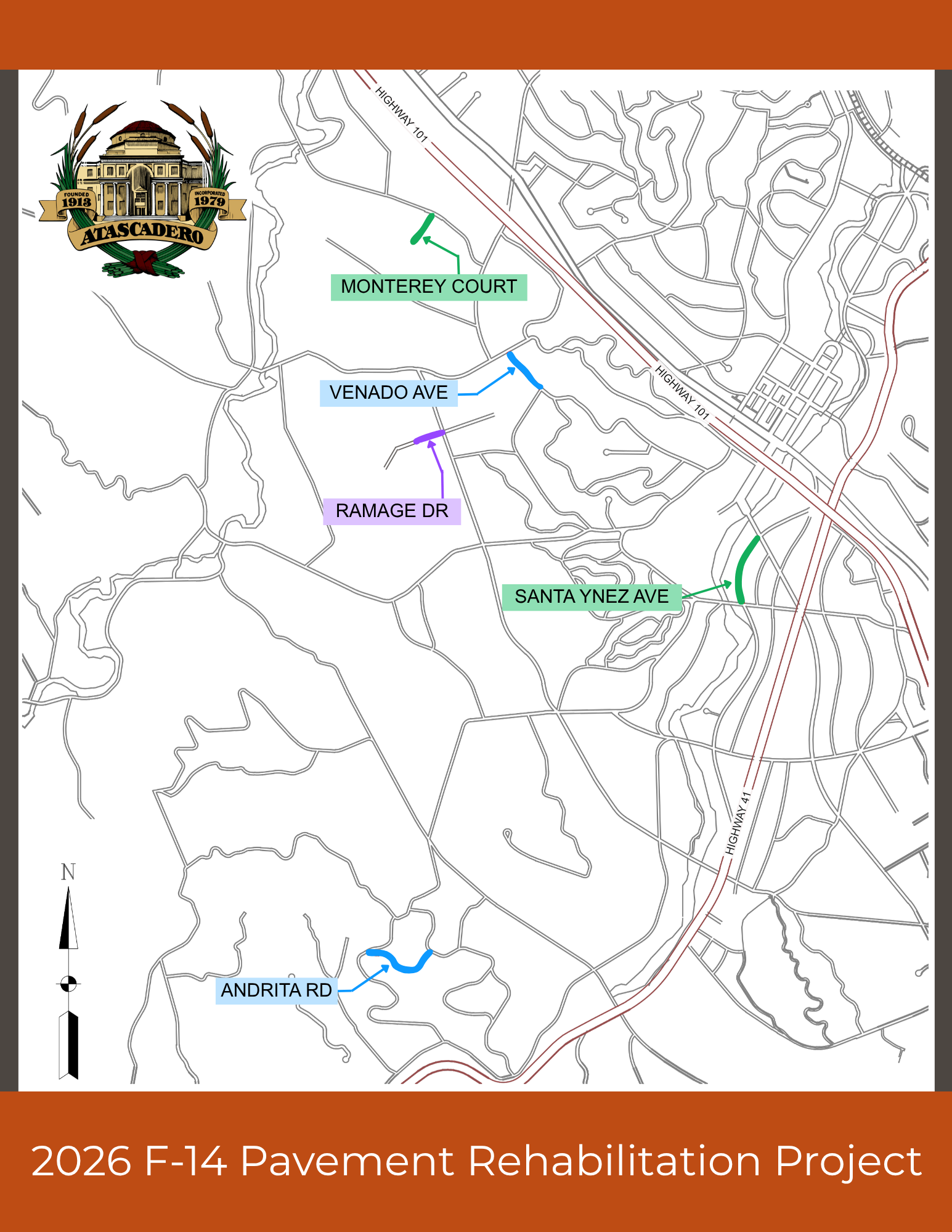

All Upcoming F-14 Road Projects
- Andrita Rd (Casanova Ave to Sierra Vista Rd) FY 2025-2026
- Ash St (Catalpa St to El Camino Real) FY 2023-2024
- Bella Vista Rd (San Marcos Rd to End) FY 2023-2024
- Birch St (Catalpa St to End) FY 2023-2024
- Capistrano Ave (Hwy 41 to Lewis Ave) FY 2023-2024
- Carmelita Ave (San Andres Ave to Curbaril Ave) FY 2023-2024
- Carmelita Rd (Portola Rd to Curbaril Ave) FY 2024-2025
- Carmelita Rd (Portola Rd to San Gabriel Rd) FY 2024-2025
- Catalpa St (North End to San Rafael Ct) FY 2023-2024
- Colorado Ave (San Rafael Rd to San Diego Way) FY 2024-2025
- Country Club Dr (Capistrano Ave to End) FY 2023-2024
- Del Rio Rd (Potrero Rd to San Anselmo Rd) FY 2023-2024
- Flores Rd (Santa Lucia Rd to Los Gatos Rd) FY 2023-2024
- Graves Creek Rd (Monterey Rd to San Fernando Rd) FY 2025-2026
- Graves Creek Rd (San Fernando Rd to Santa Ana Rd) FY 2025-2026
- Hermosa Ave (Navarette Ave to San Clemente Ave) FY 2023-2024
- Lake View Dr (Portola Rd to Santa Rosa Rd) FY 2024-2025
- Las Lomas Ave (Principal Ave to El Bordo Ave) FY 2023-2024
- Los Osos Rd (Old Morro Rd E to San Rafael Rd) FY 2024-2025
- Maple St (Catalpa St to El Camino Real) FY 2023-2024
- Monita Rd (San Gabriel Rd to Sierra Vista Rd) FY 2023-2024
- Montecito Ave (East Front Rd to Las Lomas Ave) FY 2023-2024
- Monterey Ct (Monterey Rd to End) FY 2025-2026
- Monterey Rd (Graves Creek Rd to San Anselmo Ave) FY 2024-2025
- Navajoa Ave (Atascadero Ave to San Andres Ave) FY 2024-2025
- Pinewood Ct (Catalpa St to End) FY 2023-2024
- Ramage Dr (Portola Rd to End) FY 2025-2026
- San Andres Ave (Santa Lucia Rd to San Marcos Rd) FY 2024-2025
- San Andres Ave (Marchant Ave to Atascadero Ave) FY 2024-2025
- San Andres Ave (San Marcos Rd to Hwy 41) FY 2023-2024
- San Diego Way (El Camino Real to US 101 NB Off-ramp) FY 2023-2024
- San Dimas Rd (Toloso Rd to Los Osos Rd) FY 2024-2025
- San Gabriel Rd (East Front Rd to El Camino Real) FY 2023-2024
- San Rafael Ct (West End to El Camino Real) FY 2023-2024
- Santa Ynez Ave (Atascadero Ave to San Andres Ave) FY 2025-2026
- Serra Ave (Atascadero Ave to San Andres Ave) FY 2024-2025
- Sierra Vista Rd (San Marcos Rd to Monita Rd) FY 2023-2024
- Venado Ave (Ardilla Ave to Chauplin Ave) FY 2025-2026
