El Camino Real Downtown Safety and Parking Enhancement Project

Page Title

Page Title

ECR DIEP Project Image

35.486267, -120.664896

35.490876, -120.673429

email: theECRproject@atascadero.org

main phone: 805-470-3456

Quick Overview

The project will feature enhanced pedestrian and bicycle access along with increased parking opportunities and safer crosswalks.

ECR Project Map

PLEASE DRIVE SLOWLY AND FOLLOW ALL CONSTRUCTION SIGNAGE!

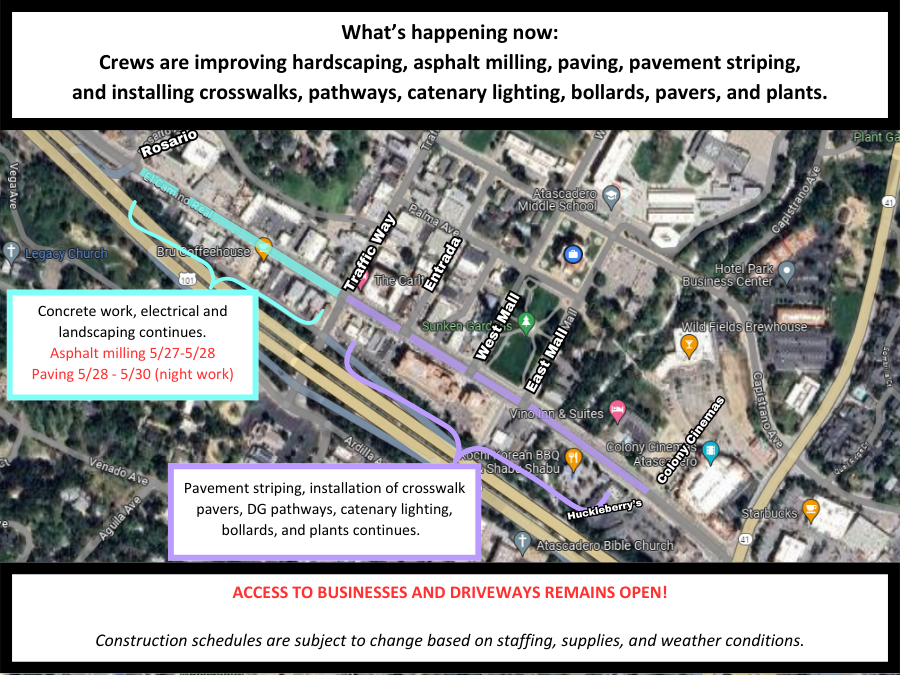

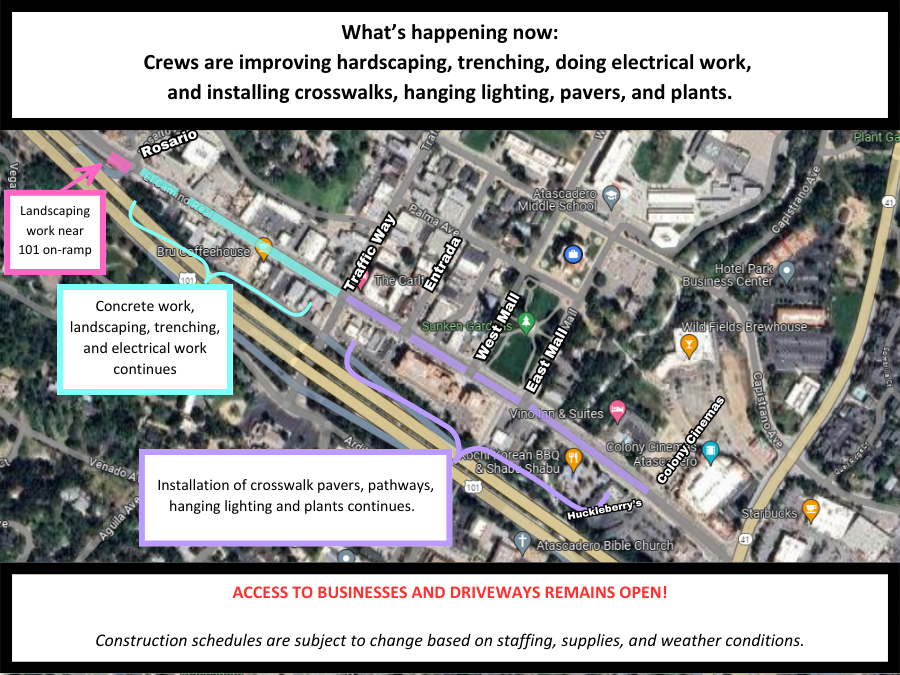

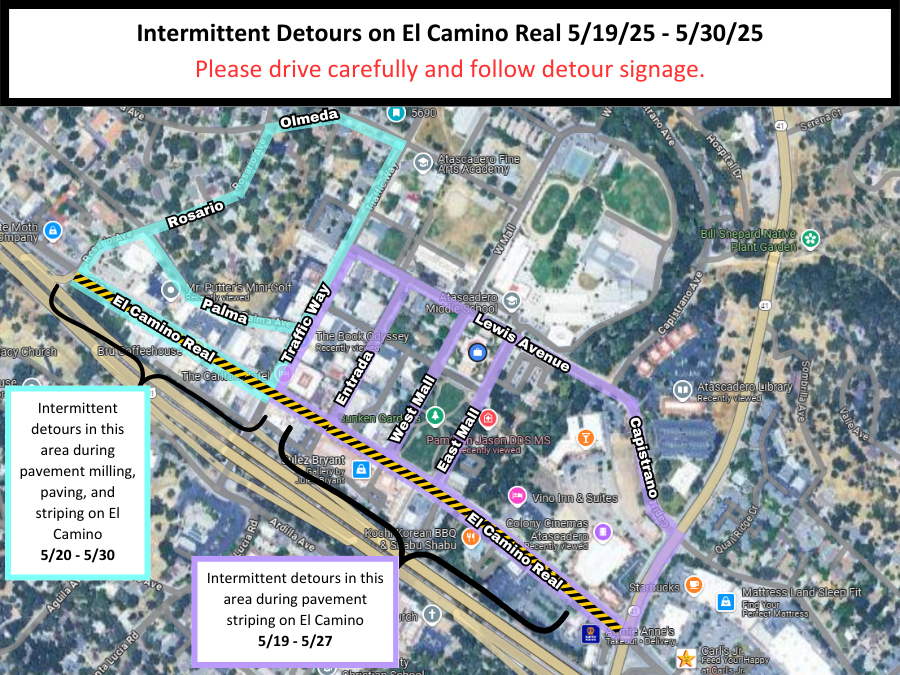

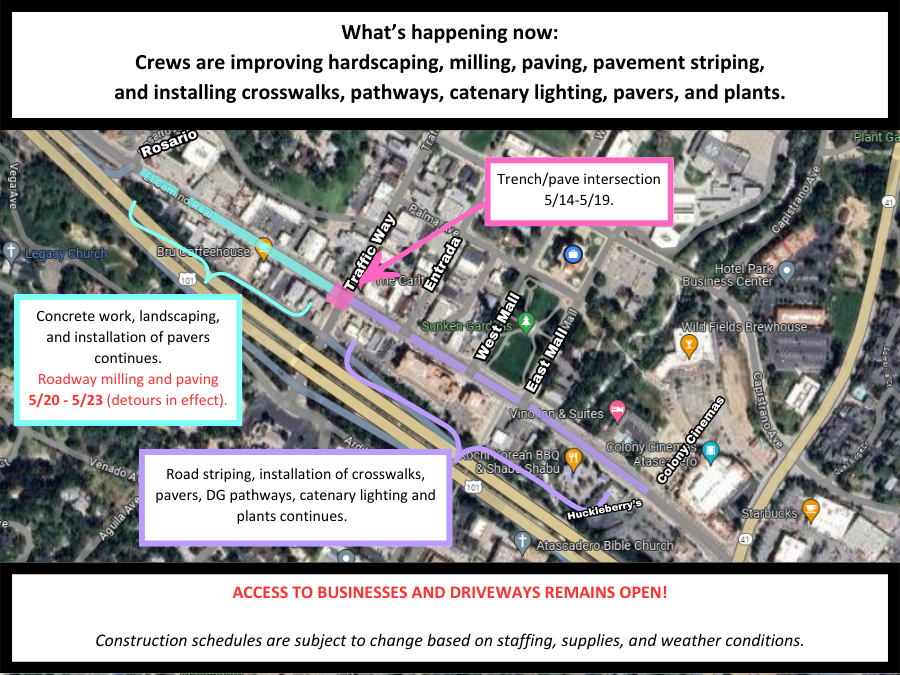

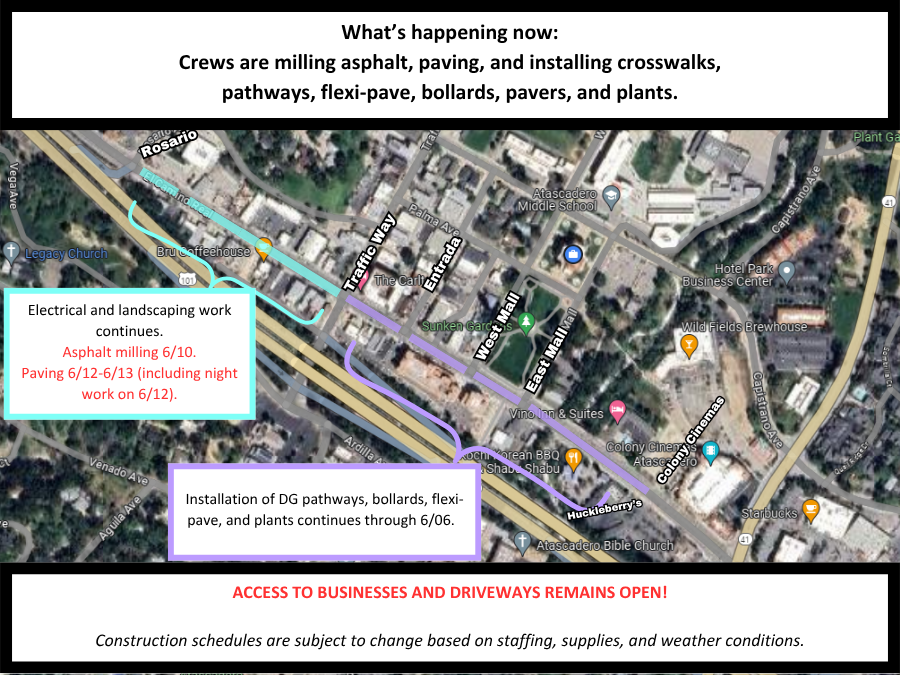

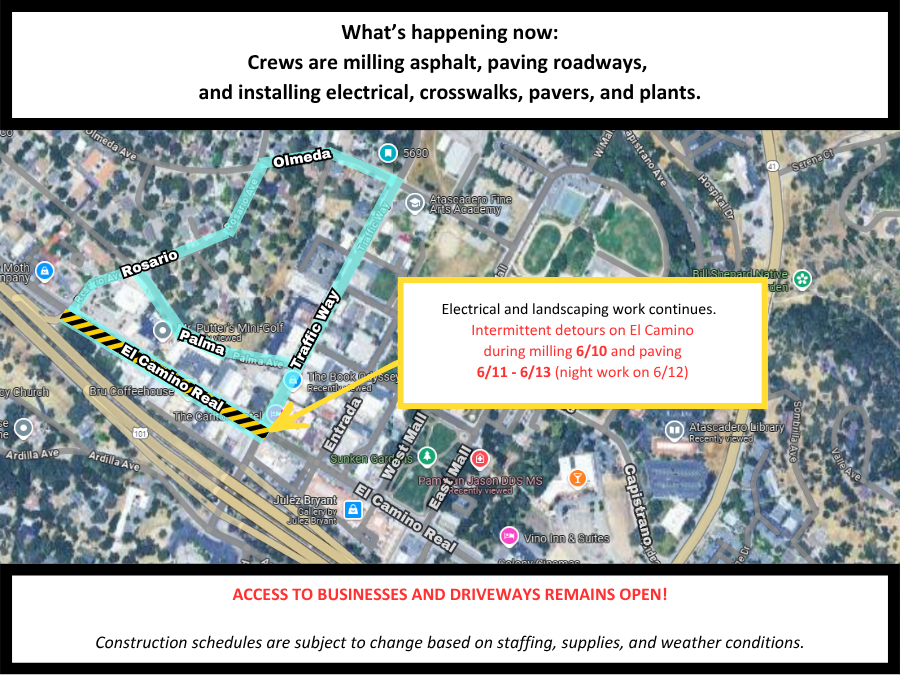

CONSTRUCTION UPDATES

Weeks of 12/09/24 - 12/20/24:

• Work continues in the median within the K-rails on El Camino Real (between Highway 41 and Traffic Way). Work includes milling pavement, roadway striping, installing pavers, concrete work on curbs/planters, and electrical/lighting work. Expect narrow travel lanes and traffic delays. The City encourages Downtown businesses to inform their delivery contacts of the temporary circulation changes on El Camino Real. Please consider alternative routes and delivery times to minimize traffic impacts.

Through traffic is maintained but may be reduced to one lane in each direction. Access to businesses and driveways remains open. No-parking areas will be marked.

Construction schedules are subject to change based on staffing, supplies, and weather conditions.

ACCESS TO BUSINESSES REMAINS OPEN!

Shop Downtown Atascadero Logo

  • Construction hours for this project are Monday-Friday, 7:00 AM - 5:00 PM.
  • Both northbound and southbound travel on El Camino Real will be maintained for the entirety of the project.
  • To sign up for "Project Alerts" and construction news, visit the News & Alerts page.
  • For questions or concerns regarding this project, please contact us at theECRproject@atascadero.org or (805) 470-3456.

Project Overview

The El Camino Real Downtown Parking and Safety Enhancements Project (The ECR Project) will improve the safety, economic vitality, parking capacity and aesthetics of the El Camino Real downtown corridor between Highway 41 and Rosario Avenue.

Planned since 2017, the ECR Project is a community-driven initiative developed in partnership with residents, businesses and community stakeholders. We thank the Atascadero community for making their voices heard during the planning process, from outreach events in 2019, to workshops in 2020, to a series of nine “open houses” in 2023.

Once constructed, the ECR Project will deliver the following improvements and benefits to this 0.6-mile stretch of El Camino Real:

  • Limit vehicular traffic on El Camino Real to one lane in each direction in the project area to increase safety, add free parking spaces and improve the Downtown experience
  • Add crosswalks with higher visibility for enhanced pedestrian safety
  • Install a full overhead signalized pedestrian crossing at East Mall to improve safety
  • Create over 100 new free parking spaces, including ADA-accessible spaces
  • Make ADA accessibility improvements, including new driveways and sidewalks
  • Plant over 25 new street trees, in-ground planters along a center median, potted planters along the sidewalk and storm runoff planters to create shade, improve aesthetics and capture water
  • Install hanging pendant lights and street lights throughout the project area
  • Create designated loading zones for deliveries, drop-offs and pickups

Throughout its development, the ECR Project has been guided by the following key priorities:

  • Community Input: The project is a community-driven initiative shaped by extensive planning and public engagement efforts over seven years to develop a holistic corridor plan that addresses the needs and goals of all multimodal users.
  • Public Safety: Research-backed enhancements will calm traffic, increase visibility for roadway users, bolster walkability and accommodate multi-modal transportation, creating a safer environment for pedestrians, cyclists, and motorists alike.
  • Economic Revitalization: Over the past five-plus years, Atascadero has experienced significant development downtown, and construction of this project is anticipated to accelerate the growth of the downtown economic district. The project’s improvements will enhance aesthetics and create a safer, easier-to-access area that can help increase foot traffic and business growth.
  • Free Parking Solutions: The project addresses concerns about parking availability by adding 118 new free parking spaces for cars, along with provisions for bicycle and motorcycle parking. This new parking will make it easier for residents and visitors to access downtown amenities, supporting local businesses and enhancing the overall downtown experience.
  • Enhanced Aesthetics: The project will enhance the aesthetics of the downtown area with features like center medians with trees and landscaping, matching gateway arches, and hanging pendant lights. These aesthetic improvements will contribute to creating a more welcoming and attractive downtown environment for residents and visitors.

Construction on the ECR Project started with utility improvements on June 10, 2024, and will be followed by streetscape construction. Work is expected to continue through Summer 2025

Throughout construction, the City will use both in-person and virtual channels to proactively communicate about potential traffic impacts to residents, businesses and schools within the downtown core. Additionally, a construction manager will be onsite at all times to answer questions from the community. Community members can sign up to receive construction news and alerts by visiting Atascadero.org/News-List.

Project Timeline

Design Development:  

  • December 2017 – November 2021

Engineering Design:  

  • January 2022 – April 2024

Construction (anticipated):

  • Utility Improvement Phase: June 2024 - Late July 2024
  • Streetscape Improvements Phase: July 2024 - Summer 2025
  • Monument Phase: Summer/Fall 2025 - Spring 2026

Project Cost and Funding Sources:

  • Budget $11,945,000
  • Funded by:
    • General Fund ($4,695,000)
    • State Legislative Grant: FY 23-25 Budget (Sen. Laird) ($3,000,000)
    • RSHA: Betterment Grants (SLOCOG) ($2,550,000)
    • Wastewater Fund: FY 23-25 Budget and Reserve ($1,120,000)
    • 2010 Bond Master Agreement ($255,000)
    • Local Transportation Fund ($140,000)
    • USHA Funds: FY 23-25 Budget ($100,000)
    • Circulation System Fund ($85,000)

History & Background

Planned since 2017, The ECR Project was envisioned by the community to enhance safety and economic development in the downtown by creating a zone that slows traffic speeds, enhances appearance and safety and best utilizes the existing roadway space.

El Camino Real in the downtown still maintains its roughly 80-foot width (curb-to-curb) and design features that reflect its past use as a highway. By dropping a vehicular lane in both the northbound and southbound directions, the City will gain space to add enhanced pedestrian and bicycle facilities, additional public spaces, and parking.

Three main factors drove the creation of the ECR Project:

  1. Atascadero is experiencing an economic upswing due to City investments and strong interest from private developers and business owners, creating more foot, vehicle, cyclist and multi-modal traffic in the Downtown area.
  2. Atascadero High School, Atascadero Fine Arts Academy, and Atascadero Middle School are located within ¼ mile of the El Camino Real Downtown Corridor, creating significant traffic during peak drop-off and pick-up times. Residents and business owners have expressed concerns regarding the safety and function of El Camino Real, and The ECR Project is designed to address these community concerns.
  3. Merchants, residents, developers, and City leaders have expressed the need for more parking and pedestrian access within the downtown district, due to increased economic activity and special events.

Atascadero has tapped several experts to assist with the ECR Project. KTUA of San Diego was hired in November 2017 and has assisted the City in El Camino Real analysis and development of a corridor plan. CCTC of Morro Bay is working as a sub-consultant to KTUA to provide traffic engineering and operations analysis.

The City hosted multiple outreach events in 2019, receiving a lot of feedback from the community. KTUA incorporated feedback from the public and the Atascadero City Council and returned a revised plan that was once again presented at multiple public workshops in 2020. After incorporating this second round of feedback, a concept plan was approved by City Council on August 11, 2020.

After the concept plan was approved, the engineering design process ramped up with additional public engagement opportunities through 2023. Contracts have been approved with Souza Construction and Filippin Engineering, Inc., and the ECR Project is now in its construction phase.

Will any parking spaces be added to Downtown with this project?

Yes. The ECR Project will add over 100 new parking spaces through the planned center median area of El Camino Real, while retaining existing curbside parking. However, some curbside parking will be modified to short-duration parking to accommodate passenger and commercial loading/unloading.

Does the project include bike lanes?

Between Highway 41 and Traffic Way, bicycles and vehicles will share a single lane of traffic on El Camino Real. The project’s design will reduce traffic speeds, creating an opportunity for cars and bicycles to share the lane safely. North of Traffic Way, new bicycle lanes will be striped adjacent to the travel lane to accommodate additional width for emergency vehicle response.

Is the crosswalk at East Mall going to be improved?

Yes. A new pedestrian signal will be installed at East Mall that will allow for a more safe and controlled flow of pedestrians crossing El Camino Real. This new signal will act like a traditional traffic signal, allowing pedestrians to cross for a set length of time before switching back to vehicular flow on El Camino Real.

Will accessible (ADA) parking be added?

Yes. Five additional ADA parking spaces are part of the planned median improvements. These spaces are clustered within the core downtown area and complement other ADA improvements, including the replacement of non-compliant curb ramps, driveway approaches and sidewalk segments.

Are electric vehicles charging stations included with this project?

There are no charging stations included with this project, but the electrical infrastructure that will be installed as part of this project will offer the opportunity for future charging stations, if available.

Will lighting be improved along El Camino Real?

Yes. This project includes comprehensive lighting upgrades along the corridor that standardize existing lights and add new lighting both along the sidewalks and in the median area. This new lighting will improve safety and the ambiance of our Downtown at night.

Will the project increase vehicle congestion Downtown?

The anticipated impacts to traffic resulting from this project were modeled by the City's traffic engineering consultant during the design phase. It is expected there will be minor impacts at peak times, most notably during school drop off and pick up times, but the project includes mitigation measures to limit traffic delays. These measures include the recently added third eastbound lane on Traffic Way at the intersection with El Camino Real, the extension of the northbound left turn lane on El Camino Real at Traffic Way and the modification of West Mall to one way (westbound) from Palma Avenue to El Camino Real.

What is the construction timeline?

Construction began on June 10, 2024, with initial work focused on underground utility replacement. Sidewalk and median improvements will follow and are expected to last through the end of 2024. Landscaping, lighting and other streetscape improvements will complete the project and that phase is expected to last through Summer 2025.  Find week-by-week construction updates at Atascadero.org/EPCProject and receive them by email by signing up for “Project Updates” on the City’s News & Alerts page.

Where can we park downtown during construction?

Construction will be phased so that portions of El Camino Real not under active construction will be open for parking. Parking will not be impacted on side streets and parking lots. It is anticipated that only a small number of parking spaces will be unavailable at any given time during construction. The City encourages everyone to continue to frequent Downtown businesses during construction and will work closely with the contractor to minimize impacts and clearly delineate safe walking paths.

Will project construction impact Downtown events, like the El Camino Cruise Night and the Colony Days Parade?

Community events, including El Camino Cruise Night and the Colony Days Parade, will continue as scheduled during project construction. El Camino Real is anticipated to remain open to traffic and will accommodate these events with potential lane closures and traffic impacts.

Anticipated traffic impacts at upcoming events:

Cruisin’ Weekend - One lane open in each direction on El Camino Real between Highway 41 and Traffic Way. Sidewalks will be open on both sides of El Camino.

Colony Days Parade - Northbound El Camino Real will have the outside lane and adjacent sidewalk open between Highway 41 and Traffic Way.

Can I still get to businesses and residences on El Camino during construction?

Yes, access to businesses and residences will remain open throughout project construction.

Does the City have plans to add paid parking downtown?

The City has no plans to add paid parking downtown. This project is constructed with the intention of adding to the free parking options and provide additional spaces within close proximity to businesses along the El Camino Real downtown corridor.

What landscaping and aesthetic improvements are part of this project?

Aesthetic elements were selected for this project with the intention of creating a comfortable, safe and cohesive style through the downtown area. These elements include lighting upgrades, pavers, site furnishings, trees and other landscaping. The intention is to transform a portion of the current 80 foot width of asphalt into a more inviting (and less hot) space for parking, events and enjoying the downtown.

What project features will help improve safety and the downtown experience for pedestrians?

The primary element of this project that will improve safety for pedestrians is the transition from five lanes of traffic to two one-lane roads. Instead of crossing five lanes of traffic, often with limited sight distance at intersections, pedestrians will now cross a single lane into a protected median at a time. Additionally, the reduced roadway width will significantly decrease traffic speeds. The combination of reduced speeds, enhanced crosswalks, and less traffic lanes fundamentally changes the feel of the downtown experience for pedestrians.

Does the City plan to close El Camino Real during construction?

El Camino Real will remain open during the duration of the project, but those visiting downtown should expect lane, shoulder or median closures over the course of the project to allow for construction. Residents are asked to drive carefully and pay attention to traffic signs, for the safety of the worker and the public.

How can I stay up to date on construction activities?

Who can I contact with questions?  The best source for staying up to date on construction activities is the City's website.  You can find week-by-week construction updates at Atascadero.org/EPCProject and receive them by email by signing up for “Project Updates” on the City’s News & Alerts page.  For project specific questions, please contact the City's Public Works Department at 470-3456.
